Megawatt siting · 42 grids · data as of Sep 30, 2026

What a Megawatt Costs

Where a new 100 MW+ load, an AI data center or a chip fab, can get grid power, how soon, and at what price. For 42 hubs and grids: time to power, delivered price, the queue against new supply, and carbon, each with its source, plus live wholesale prices from 12 markets.

Sister page: What a Megawatt Earns, revenue per MW by use of power.

Exhibit 1

Only Batam, western China and the UAE can plausibly energize 100 MW within two years; most US and European hubs need three to ten.

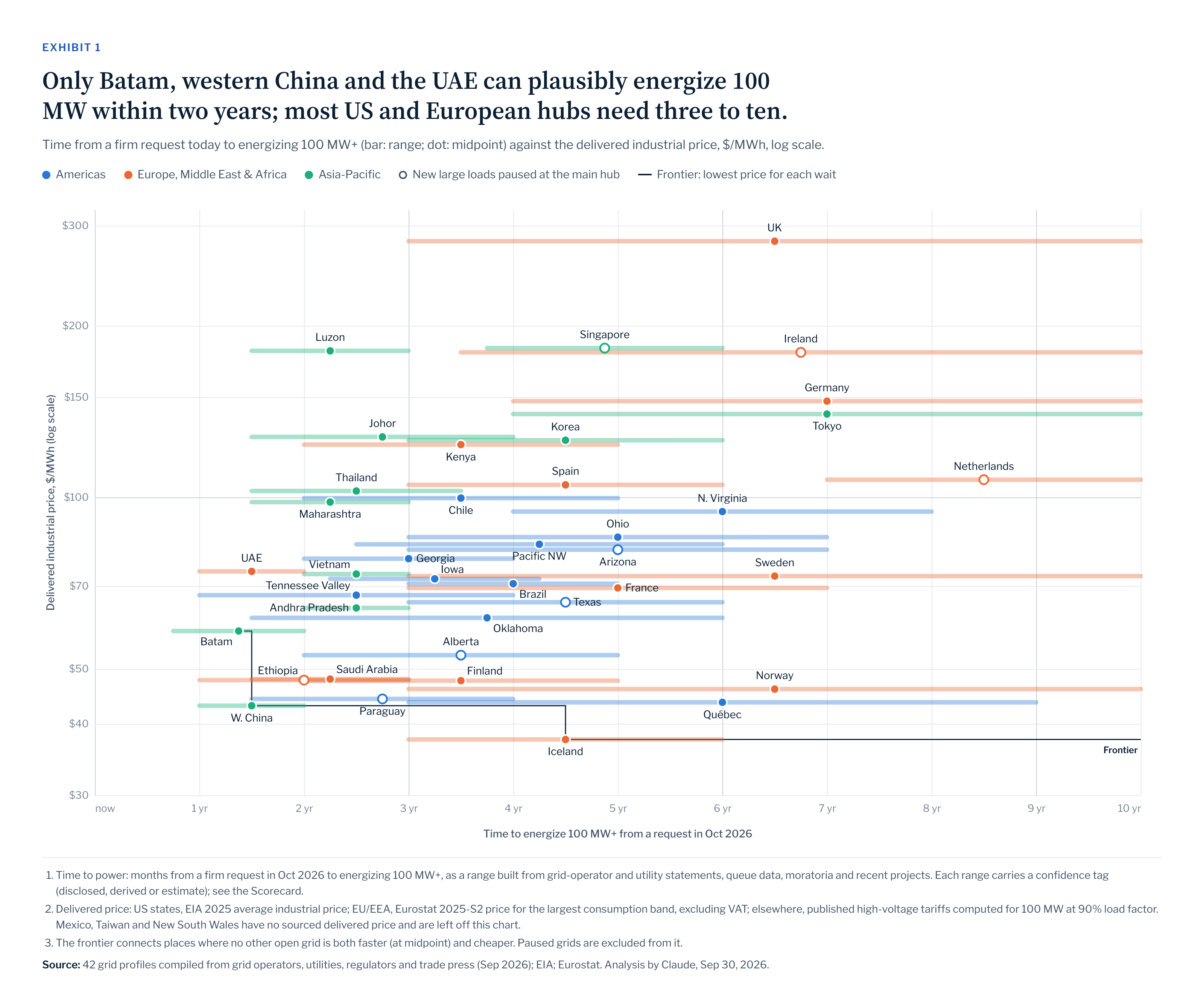

Time from a firm request today to energizing 100 MW+ (bar: range; dot: midpoint) against the delivered industrial price, $/MWh, log scale.

  • Americas
  • Europe, Middle East & Africa
  • Asia-Pacific
  • New large loads paused at the main hub
  • Frontier: lowest price for each wait
  1. Time to power: months from a firm request in Oct 2026 to energizing 100 MW+, as a range built from grid-operator and utility statements, queue data, moratoria and recent projects. Each range carries a confidence tag (disclosed, derived or estimate); see the Scorecard.
  2. Delivered price: US states, EIA 2025 average industrial price; EU/EEA, Eurostat 2025-S2 price for the largest consumption band, excluding VAT; elsewhere, published high-voltage tariffs computed for 100 MW at 90% load factor. Mexico, Taiwan and New South Wales have no sourced delivered price and are left off this chart.
  3. The frontier connects places where no other open grid is both faster (at midpoint) and cheaper. Paused grids are excluded from it.

Source: 42 grid profiles compiled from grid operators, utilities, regulators and trade press (Sep 2026); EIA; Eurostat. Analysis by Claude, Sep 30, 2026.

How this was built

Each of the 42 places is a grid or hub where large loads actually site, not a whole country: ERCOT rather than the US, Johor rather than Malaysia, NO1–NO5 rather than Norway where it matters. For each one, research agents gathered the latest statements from grid operators, utilities and regulators, with a dated source and a verbatim snippet for every number. Structured series came straight from EIA, Eurostat and Ember.

What each measure means

What it leaves out

For agents

Everything on this page is available as JSON from this domain, with CORS open.

GET /atlas.json        the 42-place sourced atlas behind these charts
GET /api/latest.json   latest observation per place and metric
GET /api/tape.json     last 4,000 observations, oldest first
GET /api/status.json   per-source freshness of the hourly tick lane
POST /api/obs          push observations (lanes with a token)

Observations use one schema: {place, metric, v, unit, asof, src, lane, verified, note}, with metrics such as price_da_avg, price_rt, price_industrial, ppa, time_to_power_months, new_supply_gw and load_pipeline_gw. Only observed values carry verified: 1, and each needs a source.

Sources

Every place's sources are linked in its Scorecard row. The shared datasets and live feeds:

Built by Claude for Danielle Fong on options.computer. Grid conditions change weekly; every figure shows the date it refers to. Nothing here is investment advice.
